Pune Ring Road: Route, Status, Villages & Completion — The Complete Guide
The Pune Ring Road is not one project — it is two concentric expressway loops being built by two different agencies at the same time: the ~172 km MSRDC outer ring road and the ~83 km PMRDA inner ring road. Together they represent one of the largest road infrastructure programmes in India, with a combined outlay well above ₹50,000 crore. This guide explains both — route, packages, contractors, villages, compensation, timeline — in one place. We manufacture construction machinery at MIDC Bhosari, twenty minutes from the alignment, and we update this page as the project moves. Last verified: July 2026.
The two ring roads, in one minute
The outer ring road, executed by the Maharashtra State Road Development Corporation (MSRDC), is a 4–6 lane access-controlled expressway of roughly 172 km circling the entire Pune district — designed for 120 kmph, built to pull inter-state and heavy vehicle traffic out of the city entirely. A truck moving from the Mumbai–Pune Expressway to the Solapur or Bengaluru highway will one day never enter Pune at all.
The inner ring road, executed by the Pune Metropolitan Region Development Authority (PMRDA), is an approximately 83 km, 65-metre-wide loop inside the outer one. Its job is different: circular connectivity between the region's growth engines — Hinjewadi IT Park, Chakan MIDC and Lohegaon Airport — so that traffic between Pune's suburbs stops funnelling through the city core.
| Parameter | Outer Ring Road (MSRDC) | Inner Ring Road (PMRDA) |
|---|---|---|
| Length | ~172 km (Eastern ~71 km + Western ~65 km, balance common/connector stretches) | ~83 km |
| Configuration | 4–6 lane access-controlled expressway, 120 kmph design speed | 65 m wide urban ring road |
| Approved cost | ~₹42,711 crore (revised from ~₹22,300 crore) | Phased; priority stretch ~₹1,196 crore (Phases 1–2 of Stage 1) |
| Talukas covered | Khed, Haveli, Purandar, Bhor, Mulshi, Maval | Khed and Haveli belt — Solu to Vadgaon Shinde as priority |
| Villages affected | 83 villages | Land parcels totalling ~721 hectares along the full loop |
| Status | Under construction — contractors mobilised across packages | Priority stretch in land acquisition / early works; DPR prepared |
Outer ring road route: where it actually goes

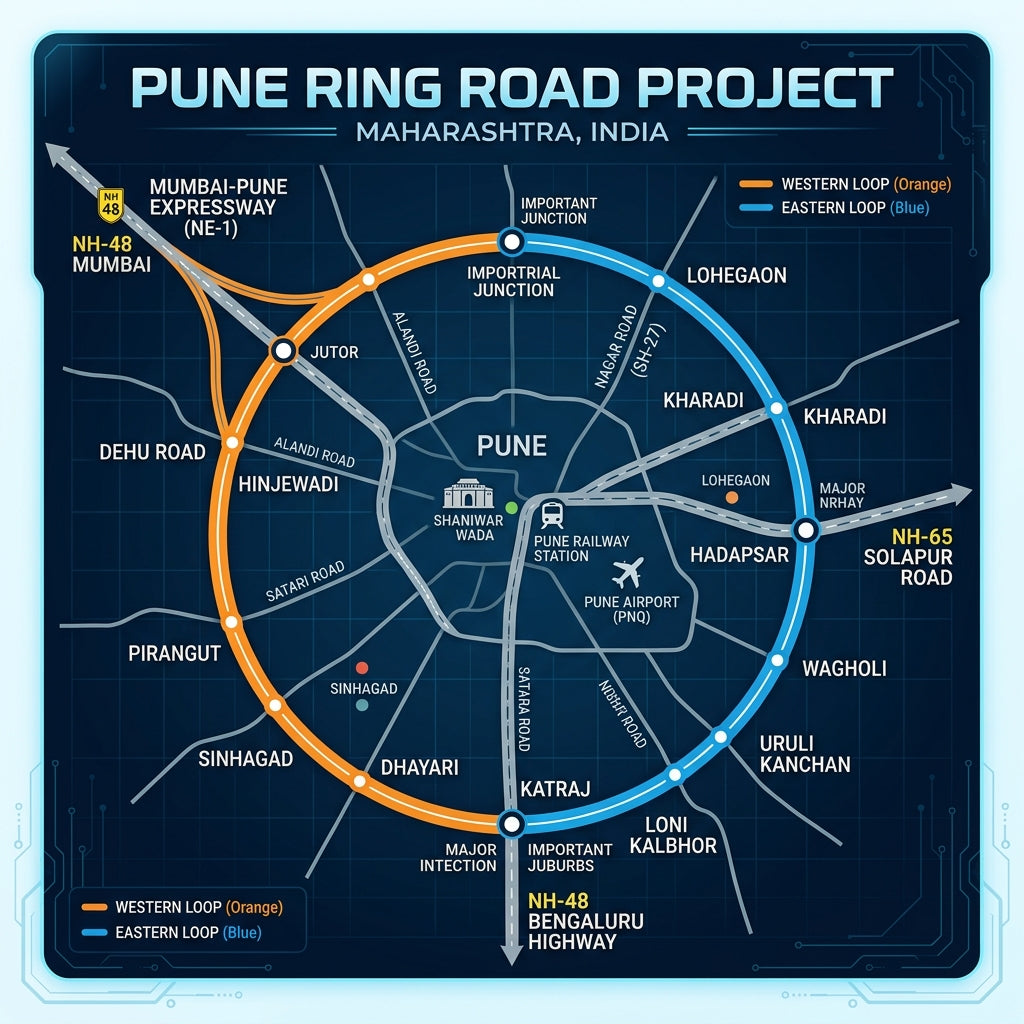

Pune Ring Road project alignment map highlighting the Eastern and Western Expressways corridor.
The MSRDC alignment is split into an Eastern Ring Road and a Western Ring Road, meeting to form the full loop around the district.
The eastern corridor runs from Urse on the Mumbai–Pune Expressway to Solu on the Alandi–Markal Road, then continues south through the district's eastern flank — crossing the Pune–Nashik highway, Pune–Ahmednagar (Nagar) Road near the Wagholi–Kesnand belt, and the Pune–Solapur highway — down toward Sorta and the Saswad side. This is the corridor that unlocks the eastern logistics belt: Wagholi, Kesnand, Loni Kalbhor and the Ranjangaon MIDC feeder routes.
The western corridor runs from Urse down to Varve Budruk on the Pune–Satara Road, threading the harder terrain — the Mulshi and Bhor hills. This is where the heavy engineering lives: the project includes 8 tunnels totalling 11.29 km, major bridges, and a roughly half-kilometre bridge across the backwaters of Khadakwasla dam.
Every national highway radiating out of Pune — Mumbai–Pune Expressway, NH-48 to Bengaluru, Pune–Solapur, Pune–Nashik, Pune–Ahmednagar and the Saswad/Purandar side serving the upcoming international airport — gets an interchange on the loop. That interchange map is why land near the alignment has become the district's most-watched real estate.
Packages and contractors: who is building it
Heavy machinery and earthmoving equipment deployed for the formation work along the alignment corridor.
The civil work is divided into 12 packages — 7 on the Eastern Ring Road and 5 on the Western — awarded through competitive bidding that drew India's biggest road builders. The contractors mobilised across packages include Megha Engineering (MEIL), Navayuga Engineering, GR Infraprojects, PNC Infratech, Roadway Solutions India Infra (RSIIL) and Afcons on eastern packages, with each package running on an aggressive construction schedule of roughly 900 days from appointed date.
Ground activity is visible today. On the eastern side, RSIIL's package connecting Nagar Road to the Solapur highway (about 24.5 km) mobilised from a base at Wadebolai village near Kesnand with over a hundred excavators and earthmoving machines deployed for land levelling and formation work. Similar mobilisation is underway package by package as encumbrance-free land is handed over.
Land acquisition and compensation
Land acquisition — the stage that stalls most Indian expressways — is substantially complete on the outer ring: around 98% of the roughly 1,740 hectares required has been acquired across the 83 villages, most of it private land. Compensation was set at up to five times the Ready Reckoner Rate (or the highest recent transaction benchmark, whichever is higher), which is the single biggest reason acquisition moved faster here than on comparable projects. Over ₹11,000 crore was earmarked for land alone, financed in part through HUDCO borrowing approved by the state cabinet.
On the inner ring road, the government granted a Social Impact Assessment exemption covering the full alignment (~721 hectares), and joint measurement and valuation have been completed village by village on the priority stretch, with acquisition proposals for the Haveli taluka villages submitted to the District Collector.
Timeline: when will the Pune Ring Road be completed
Dates on this project have moved several times, so treat any single deadline with caution — but the current working structure is this: construction on the outer ring road formally began in late 2024, with contractors mobilising through 2025. Each package carries a construction period of roughly 30 months / 900 days, which points to the outer ring road targeting completion around late 2027 to 2028, package by package rather than all at once — expect eastern flatland packages to finish before the tunnel-heavy western ones. The full dual-ring network, including the PMRDA inner ring road, is anticipated to be operational around 2030.
The inner ring road is being delivered in stages, with the Solu Interchange–Nirgudi–Vadgaon Shinde priority stretch (connecting the Mumbai–Pune Expressway side to Pune–Ahmednagar Road) sequenced first.
What the ring road changes for Pune
Traffic: the outer ring's core purpose is to remove long-distance and heavy commercial traffic from city roads. Trucks between Mumbai, Solapur, Bengaluru, Nashik and Ahmednagar corridors bypass Pune entirely — the estimate most often cited by state officials is a reduction of roughly a quarter in city congestion and associated pollution once the loop closes.
Real estate and industry: every interchange is a future growth node. The Wagholi–Kesnand–Loni Kalbhor arc, the Chakan–Khed belt, the Saswad/Purandar side near the planned international airport, and the Talegaon–Urse gateway are already repricing. Industrial land near the alignment — warehousing on the eastern arc especially — is the earliest mover, because logistics parks value ring-road access before homebuyers do.
Construction economy: a programme of this scale runs on thousands of machines and hundreds of subcontractors. Formation work needs excavators, rollers and compactors; the 8 tunnels, dozens of bridges and every interchange run on cut-and-bent reinforcement steel processed by bar bending and bar cutting machines; and the service roads, toll plazas and structures need concrete finishing equipment. We see this demand directly at our factory gate in Bhosari — rebar yards along the eastern packages have been scaling up since mobilisation began.
Outer vs inner: which one affects you
A simple way to keep them straight: if your concern is inter-city travel, logistics, or land on the district's edge, watch the MSRDC outer ring road. If your concern is daily commuting between Pune's suburbs — Hinjewadi to Chakan, airport access, the Solu–Vadgaon Shinde corridor — watch the PMRDA inner ring road. Both are funded, both have statutory land processes substantially cleared, and both are physically underway on their lead sections, which puts this programme past the point where Pune megaprojects historically stalled.
Frequently asked questions
What is the Pune Ring Road project?
It is a dual-loop expressway programme around Pune: a ~172 km outer ring road built by MSRDC as a 4–6 lane access-controlled expressway, and a ~83 km inner ring road built by PMRDA to connect Hinjewadi, Chakan MIDC and Lohegaon Airport. Combined cost exceeds ₹50,000 crore.
When will the Pune Ring Road be completed?
Construction packages on the outer ring road carry roughly 900-day schedules from their appointed dates, pointing to completion around late 2027–2028 for the outer loop, with the full dual-ring network anticipated to be operational around 2030. Timelines have shifted before and should be treated as targets.
Which villages and talukas does the ring road pass through?
The outer ring road crosses 83 villages across six talukas of Pune district: Khed, Haveli, Purandar, Bhor, Mulshi and Maval. The eastern corridor runs Urse–Solu–Sorta crossing the Nashik, Nagar and Solapur highways; the western corridor runs Urse to Varve Budruk on Satara Road.
Who is constructing the Pune Ring Road?
MSRDC has divided the outer ring road into 12 civil packages (7 eastern, 5 western) awarded to major contractors including Megha Engineering, Navayuga Engineering, GR Infraprojects, PNC Infratech, Roadway Solutions India Infra and Afcons Infrastructure.
What compensation are landowners getting?
Compensation of up to five times the Ready Reckoner Rate — or the highest recent transaction benchmark, whichever is higher — with over ₹11,000 crore earmarked for land acquisition. Around 98% of the required ~1,740 hectares has been acquired.
What is the difference between the inner and outer ring road?
The outer ring road (MSRDC, ~172 km) diverts inter-city and heavy vehicle traffic around the district at expressway speeds. The inner ring road (PMRDA, ~83 km) improves connectivity between Pune's own suburbs and employment hubs. They are separate projects by separate agencies, built concurrently.
Will the ring road include tunnels and bridges?
Yes — the outer ring road includes 8 tunnels totalling 11.29 km, primarily on the western corridor through the Mulshi–Bhor terrain, plus major bridges including an approximately 500-metre span across the Khadakwasla dam backwaters.
Building along the ring road corridor?
Jamshedji Constro Equip manufactures bar bending, bar cutting, compaction and concrete finishing machines at MIDC Bhosari — factory-gate prices, GST invoice, same or next-day delivery across the Pune district, including every ring-road package zone.
Sources: MSRDC and PMRDA official project disclosures, Maharashtra cabinet approvals, and reporting by The Metro Rail Guy, Hindustan Times, Free Press Journal and infrastructure trade publications. Figures reflect the latest publicly available information and are updated as the project progresses.
